We knew we wanted to have a webpage to document our home build process. It's been a long journey and one we want to be able to look back on. After the project started going downhill we realized documenting it was must.
Saturday, February 27, 2021
Mold
Thursday, February 25, 2021
New project manager
The most recent project manager started in July, he quit last week, no notice.
We now have the same project manager who started the project back in May. He was the one on the job when all the framing went south, so I am not excited.
We still haven't passed shear inspection because no one has returned to take off the housewrap.
We met with the GC management team yesterday via zoom to discuss converting our contract to a shell build instead of having them finish the project. The downside is that we need to find a GC that would be willing to pickup where they left off. We also need to agree on a dollar amount. You would think we would pay them according to the draw schedule and then move on, but they threw some ridiculous numbers at us. Still waiting for an email from them on how they calculated their figures.
No new pictures to report.
Friday, February 19, 2021
3rd try on Shear Inspection
Today is the 3rd try on the shear inspection. The GC sent 2 project managers yesterday to remove the paper after we failed inspection a week ago. The inspector asked for all housewrap to be removed. This is where we stand today for inspection.
Update-inspection failed
Tuesday, February 16, 2021
HVAC, Roof and snow
HVAC guys were quick - in and out in 1/2 a day!
Wednesday, February 10, 2021
Missed inspection?
I contacted GC last week after logging into County's permit status page to look at the inspections on the project. I let GC know the sheer wall inspection was approved yet. I was told it was done in October. Sure, yes it was done back in October, but FAILED because the sheathing wasn't finished because we were waiting for the framers to finish trusses!
Apparently they (GC) had marked it off their list. Meanwhile they had the house wrapped in Tyvec. On 2/5 I sent them this screenshot showing that the sheer was not approved. On 2/9 the coordinator for the projected said "I was told we passed that inspection but I have re requested it.". Fast forward to today 2/10, the project manager came out to expose some of the nailing patterns and the earthquake straps hoping we would pass the inspection . . .NOPE the county inspector shows up and says "It all has to come off", "I need to see all the nails".
Now I wonder . . What would have happened if I didn't lookup the inspection status and sent the screenshot on the 5th. The siding crew is supposed to be here next week for siding!? I guess it could have been worse if it hadn't been caught and called in this week. We would be removing siding?? Come on guys.

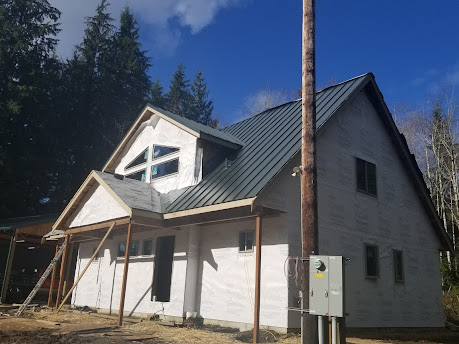

Tuesday, February 9, 2021
More roofing and blue skies
Wednesday, February 3, 2021

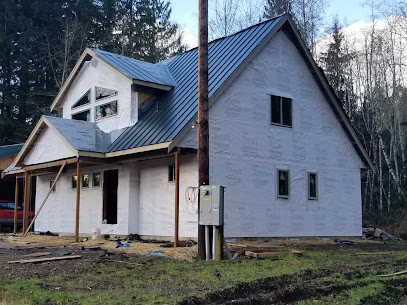

One step closer to dry in
Yesterday the electrician came by to drop supplies, but couldn't since the roof wasn't on. Today was bright and sunny but the roofers still didn't show. I was told they can't work in rain or wind on the metal roof (ok makes sense), but today was neither of those. New timeline for roof "by Friday the 12th". They were only were 1 day, last Thursday.
Our house does look totally different today though. House wrap when on . . so we are one step closer to dry out!
Cedar deck complete, tiled porch . . still in progress
